The Saturn V was qualified by flying all three of its stages on its first launch; this issue follows the 1962 mission-mode decision that fixed its size, the engine that took six years to stabilise, and the two flights that exposed faults the ground tests had hidden.
| What it is | The figure | What the figure forced |
|---|---|---|
| Mission mode | Lunar orbit rendezvous, announced by NASA on 7 November 1962 | The landing craft flew separately and rejoined a mother ship in lunar orbit, which removed the need for a direct-ascent vehicle several times larger. 3 |
| Vehicle | 111 m tall, 10 m in diameter, about 2,970 t at liftoff | Payload was a small fraction of the launch mass; the S-IC stage alone was about 94 percent propellant. 3 |

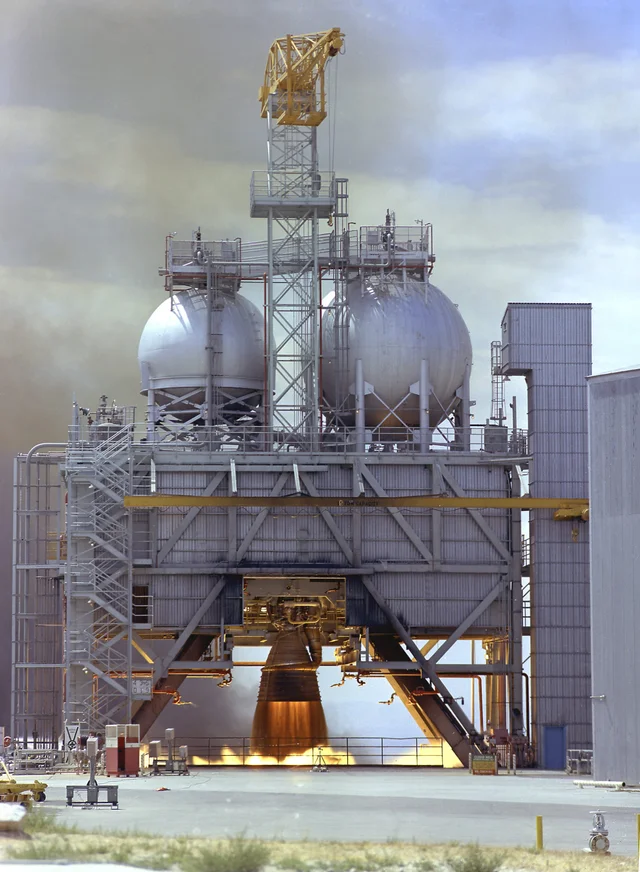

| First stage | Five F-1 engines, 33,000 kN (7.5 million lbf) at sea level, about 150 seconds of burn | The five engines together produced roughly 1.2 times the loaded vehicle's weight, so the stack was held down by four points on its thrust structure until all five reached thrust. 3 |

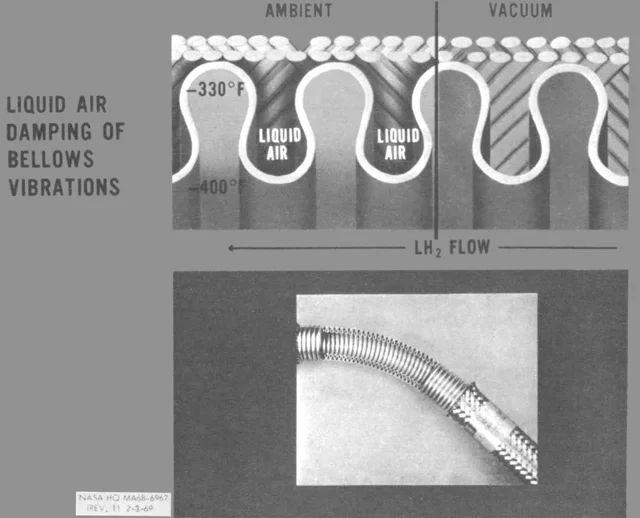

| Second stage | Five J-2 engines burning liquid hydrogen, 4,400 kN in vacuum | Hydrogen's low density made the tank large and its insulation the difficult part; more than 90 percent of the loaded stage was propellant. 34 |
| Third stage | One restartable J-2, two burns of 165 and 312 seconds | The restart converted a parking orbit into a lunar trajectory, and it was the step that failed on Apollo 6. 35 |
| Payload | 140,000 kg to low Earth orbit, 43,500 kg toward the Moon | The low-orbit figure is still the largest of any rocket, and about 60 percent more than the 2026 vehicle sends toward the Moon. 23 |

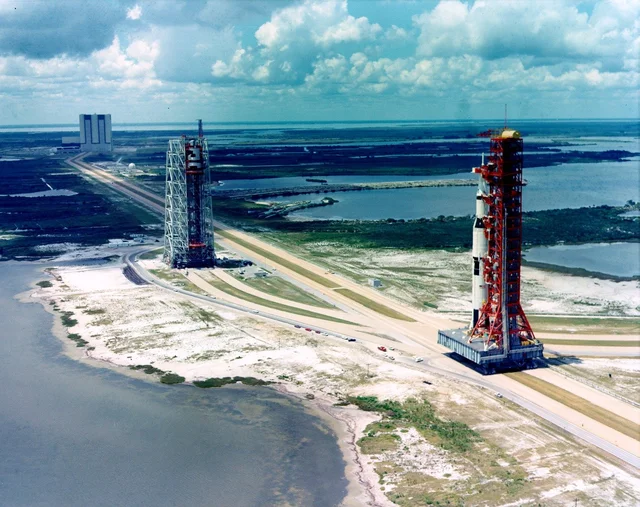

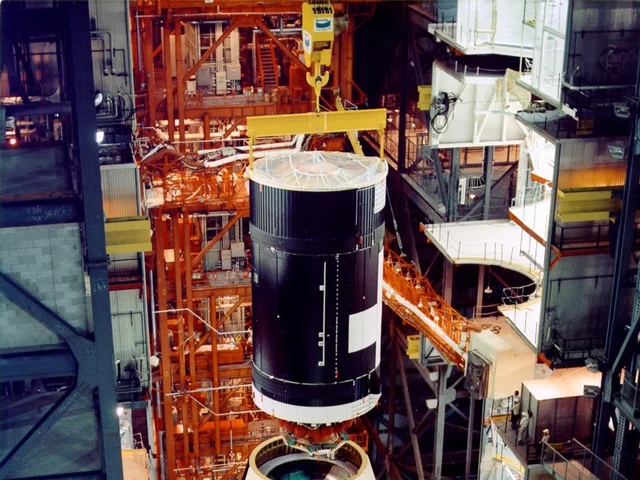

| Assembly | Stacked in a building 160 m tall and 3,665,000 m³ in volume, then driven 5.535 km to the pad | Every stage had to reach Florida by water or by air, because the stages were too massive to move any other way. 36 |

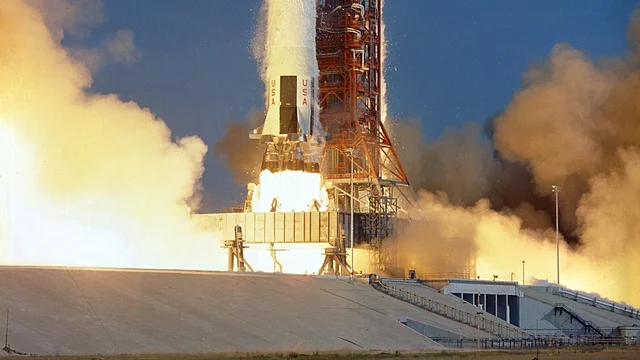

| Flight testing | Two uncrewed flights, 9 November 1967 and 4 April 1968 | The first flew a complete vehicle and spacecraft; the second exposed two faults that ground testing had concealed. 57 |
| Flights | 13 launches, 12 successes, one partial failure | Nine of them carried crews toward the Moon between December 1968 and December 1972. 3 |
| Cost | $6.417 billion appropriated for development and flights from 1964 to 1973; $185 million per mission in 1969–71 | About $995 million per launch in 2024 dollars, spent against a deadline rather than a requirement. 3 |
